How to Build a Prototype Lamination Stack Fast: Cut Lead Time from Weeks to Days

A prototype lamination stack can move fast. Not always. But often faster than the first quote suggests.

The delay usually starts before cutting. The drawing is almost ready, the material is “standard,” the stack height is “around 40 mm,” and the team wants it “as soon as possible.” That sounds clear inside the project. To a manufacturer, it is not clear enough to release work.

This playbook is for engineers, buyers, and project owners who need a custom lamination stack for a motor core, stator, rotor, transformer, actuator, generator, or magnetic test build without waiting for full production tooling.

The goal is simple: get a useful prototype built fast, without making decisions that ruin the data later.

Table of Contents


Quick Answer: How Fast Can a Prototype Lamination Stack Be Made?

For early-stage prototype lamination stacks, the fastest route is usually laser-cut laminations from available electrical steel, followed by simple stacking, welding, bonding, or fixture assembly.

Typical planning ranges look like this:

Prototype routeTypical lead-time targetBest use caseMain risk
Laser-cut loose lamination set3–7 business daysFit check, winding trial, fixture testNot a finished stack
Laser-cut welded stack1–2 weeksFunctional motor core prototypeHeat and local distortion
Laser-cut bonded stack1–3 weeksCleaner assembled stator or rotor coreAdhesive cure and stack height control
Wire EDM lamination stack1–3 weeksTight features, fine slots, small batchesSlower cutting speed
Chemically etched laminations1–3 weeksVery thin laminations, fine geometryMaterial and thickness limits
Prototype stamping or soft tooling3–6+ weeksPre-production validationTooling delay
Full production stamping tool6–12+ weeksStable high-volume designExpensive if geometry changes

These are planning ranges, not promises. Material availability, lamination thickness, OD size, feature density, stack height, inspection level, and finishing steps can change the schedule quickly.

Still, the rule holds: if you need speed, avoid hard tooling until the geometry earns it.


What Makes a Lamination Stack Slow?

A lamination stack is not just many thin metal sheets.

It is a controlled magnetic assembly. Cutting changes the edge. Burrs affect insulation. Welding changes local heat. Bonding changes stack height. Stress relief changes magnetic behavior. Even the way you measure stack height can cause arguments.

Most slow projects have one of these problems:

Delay sourceWhy it slows the buildFast fix
Undefined materialSupplier must confirm grade, coating, and thicknessGive preferred and acceptable substitute materials
No DXF/DWG filePDF-only drawings create programming delaysSend clean 2D cutting files
Every dimension marked criticalInspection becomes too heavyMark only functional dimensions as critical
Unknown stack methodAssembly quote cannot be finishedChoose loose, welded, bonded, pinned, or clamped
No burr requirementRework risk increasesDefine burr direction and maximum burr if needed
Vague stack heightLamination count and compression are unclearState target height and measurement condition
Production intent too earlyTooling and process reviews add weeksUse no-tool prototype route first

A fast prototype starts with a narrow question. “Can this slot be wound?” is narrow. “Can this design become our final production motor core?” is not.


Step 1: Decide What This Prototype Must Prove

Before choosing laser cutting, wire EDM, bonding, welding, or stamping, decide what the stack is supposed to prove.

Do not skip this. It saves days.

Prototype goalOptimize forYou can usually relax
Mechanical fitOD, ID, bolt holes, shaft fit, stack heightFinal magnetic loss
Winding trialSlot opening, tooth shape, insulation clearanceFinal joining method
Spin testConcentricity, balance, rotor retentionCosmetic edge finish
Thermal testStack contact, housing fit, winding fillPerfect magnetic grade
Magnetic testSteel grade, cutting method, burr control, stress reliefFastest possible build
Customer sampleClean assembly, safe handling, visual finishFull production economics

A geometry prototype and a magnetic validation prototype should not use the same rules.

That sounds obvious. It gets missed constantly.

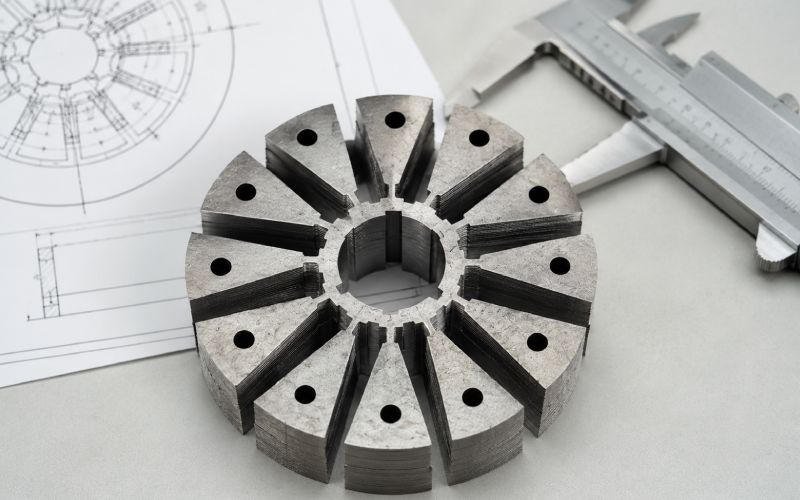

Top view of a prototype lamination stack

Step 2: Choose the Fastest Manufacturing Route That Still Matches the Test

Laser cutting for quick-turn stator and rotor laminations

Laser cutting is usually the fastest path for a prototype lamination stack because it needs no dedicated stamping tool. It is well suited for custom stator laminations, prototype rotor laminations, electrical steel lamination samples, and fast motor core prototyping.

Use laser cutting when:

  • the design may still change
  • you need parts in days, not months
  • the quantity is low
  • the geometry is complex but not extremely fine
  • fit, winding, packaging, or early functional testing is the main goal

Watch the edge condition. Laser cutting can create heat-affected zones and stress near the cut edge. For a fit prototype, that may not matter. For a core loss study, it may matter a lot.

Bottom line: choose laser cutting when speed and geometry flexibility matter more than final magnetic certainty.


Wire EDM for tight prototype laminations

Wire EDM is slower than laser cutting in many cases, but it can be useful when the lamination has narrow bridges, fine slot features, small radii, or tight profile requirements.

Use wire EDM when:

  • the profile tolerance is tight
  • the batch is small
  • the material is hard to cut cleanly by other methods
  • the prototype must match delicate features
  • slower lead time is acceptable for better detail control

Wire EDM is not magic. It still needs programming, fixturing, and inspection. But for fine-feature prototypes, it can prevent the “fast but wrong” problem.

Bottom line: choose wire EDM when accuracy is worth more than the shortest calendar time.


Stamping for pre-production, not first learning

Stamping makes sense when the design is stable and the expected volume justifies tooling. For the first lamination stack prototype, stamping is often too slow and too expensive.

Use stamping when:

  • geometry is frozen
  • quantity is high enough
  • production process validation is required
  • interlocking or production stacking features must be tested
  • unit cost matters more than first-piece speed

Bottom line: stamping is excellent after the design settles. It is usually a poor first move when the drawing is still changing.


Step 3: Lock the RFQ Pack Before Asking for Speed

If you want a short lead time, send a complete manufacturing pack. Not a half-pack with notes scattered across email threads.

A useful RFQ pack for a prototype lamination stack includes:

RFQ itemWhat to send
Lamination geometryDXF or DWG file, plus PDF drawing
Stack modelSTEP file if available
ApplicationStator, rotor, transformer, actuator, generator, test coupon
MaterialElectrical steel grade, thickness, coating, allowed substitutes
QuantityNumber of stacks, spare laminations, test coupons
Stack heightTarget height and tolerance
Lamination countFixed count or adjusted to target height
Cutting methodLaser, wire EDM, etching, stamping, or open to recommendation
Stacking methodLoose, welded, bonded, riveted, pinned, clamped
Burr requirementMax burr, burr direction, deburring allowed or not
Heat treatmentRequired, optional, or not allowed
Critical dimensionsBore, OD, slot, tooth, magnet pocket, datum features
InspectionBasic dimensional check or full report
TimelineRequired ship date and flexible items

Here is the small but useful phrase to add:

“If any requirement increases lead time, please identify it separately.”

That one sentence can expose the real blocker. Maybe it is not the cutting. Maybe it is the material. Maybe it is one over-tight tolerance on a non-critical feature.


Step 4: Control Stack Height the Practical Way

Stack height causes more trouble than it should.

A lamination stack is made from coated sheets. The coating, burrs, flatness, pressure, bonding layer, weld distortion, and sheet thickness variation all affect final height. So “40 mm stack height” is not enough.

Specify stack height like this:

Target stack height: 40.00 mm ±0.10 mm, measured under defined compression after stacking.

Or, if lamination count matters more:

Build with 120 laminations. Final stack height to be reported, not adjusted.

Those are different builds.

For fast prototypes, choose one priority:

  • exact lamination count
  • exact stack height
  • exact active steel length
  • exact fit inside a housing

You may want all four. Fine. But one should lead.


Step 5: Pick the Stacking Method Early

The stacking method changes the prototype’s stiffness, handling, magnetic behavior, and delivery time.

Stacking methodSpeedBest forWatch-out
Loose stackFastestFit checks, winding trials, lab fixturesPoor handling
Clamped stackFastMagnetic coupons, temporary testingFixture affects result
Welded stackFastRigid prototype motor coresHeat and local shorting risk
Bonded stackMediumCleaner stack, less metal joiningCure time and adhesive thickness
Riveted or pinned stackMediumMechanical alignmentExtra holes may affect flux path
Interlocked stackSlower for prototypesProduction-style validationUsually needs tooling or added features

For a quick-turn stator lamination stack, welding may be acceptable if the test is mechanical or thermal. For a magnetic loss test, bonding or controlled clamping may give cleaner data.

No single method is best. The test decides.


Step 6: Do Not Over-Specify the First Build

This is where prototypes get heavy.

A first build does not always need final coating approval, final joining method, full inspection, final steel grade, stress relief, and perfect cosmetics. Some do. Most do not.

A faster first build may allow:

  • available equivalent material
  • wider non-critical tolerances
  • laser-cut edges with agreed visual limits
  • simplified vent holes or temporary features
  • reported stack height instead of tightly adjusted height
  • basic inspection on critical dimensions only

Do not relax the bore if it controls shaft fit. Do not relax slot opening if winding access is the test. Do not relax magnet pocket geometry if retention is the question.

Relax the things that do not answer the current question.

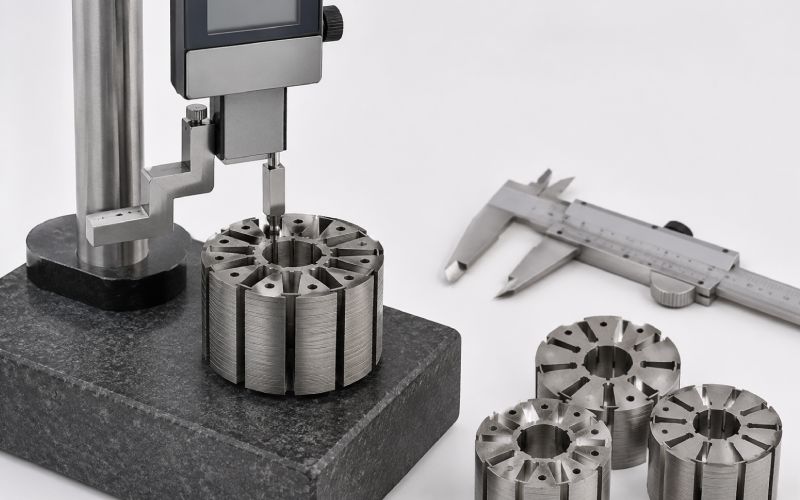

Inspection of a prototype lamination stack

Step 7: Add Spares and Coupons

Order extra laminations. Always.

Prototype laminations get scratched, bent, dropped, over-pressed, mis-stacked, or consumed in inspection. A winding trial can damage a tooth. A rotor trial can expose a burr issue. A bonded stack may need a section cut.

A good prototype order often includes:

  • the required finished stack quantity
  • 5–15% spare laminations
  • one partial stack for destructive checks
  • simple coupons from the same material and cutting process
  • extra end laminations if welding or bonding will be adjusted

This adds a small cost. It can save a second procurement cycle.


Fast-Track Build Plan: From Drawing to Prototype Stack

Use this three-stage path when the project is urgent and the design is still moving.

Build 1: Geometry stack

Purpose: fit, assembly, winding access, housing clearance.

Best route: laser-cut available material, loose or lightly fixed stack.

Lead-time target: days to about one week.

Do not use this build to make final efficiency claims.

Build 2: Functional stack

Purpose: winding, thermal test, spin test, early electrical test.

Best route: closer material, controlled burr direction, welded or bonded assembly.

Lead-time target: one to three weeks.

This is where most design mistakes show up.

Build 3: Magnetic validation stack

Purpose: core loss, efficiency, material comparison, simulation correlation.

Best route: locked material, controlled cutting method, defined stress relief decision, documented inspection.

Lead-time target: longer, because the data matters.

This staged plan feels slower on paper. It often wins in real projects because the first build catches simple errors before the expensive build starts.


What to Send for a Fast Feasibility Check

If you need a quick-turn prototype lamination stack, prepare this short package:

  1. DXF or DWG lamination profile
  2. PDF drawing with critical dimensions marked
  3. Material grade, thickness, and coating requirement
  4. Target stack height or lamination count
  5. Quantity and spare requirement
  6. Stator, rotor, transformer, or other application
  7. Preferred stacking method
  8. Required delivery date
  9. What the prototype must prove
  10. Any dimensions that cannot change

A fast review is only possible when the file tells the truth. If the design is still rough, say so. A rough design can still be quoted, but it should not be treated like a released drawing.


Common Lead-Time Traps

Trap 1: Asking for “production quality” without production decisions

Production quality needs production rules. Material locked. Tooling path known. Inspection defined. Joining method chosen. If those decisions are not ready, the phrase adds confusion.

Trap 2: Treating burrs as cosmetic

Burrs can affect stacking, insulation, local shorting, and measurement repeatability. For magnetic prototypes, burr control is functional.

Trap 3: Changing material after quoting

Changing from one electrical steel grade or thickness to another can change stack height, lamination count, cutting behavior, coating, and magnetic performance. That is not a small edit.

Trap 4: Using the first prototype for every test

One prototype cannot answer everything equally well. A fast fit stack is not automatically a magnetic validation stack.

Trap 5: Sending only a 3D model

A 3D model helps, but lamination cutting usually needs clean 2D profile data. Send both if possible.


FAQ: Prototype Lamination Stack Lead Time

How long does a prototype lamination stack take?

A simple laser-cut lamination set can often be planned in days. A finished welded or bonded stack is more commonly planned around one to three weeks. Tooling-based prototypes can take several weeks or more. The exact time depends on material, thickness, geometry, stack height, finishing, and inspection.

Laser cutting vs. wire EDM for motor laminations: which is faster?

Laser cutting is usually faster for quick-turn stator laminations and rotor laminations. Wire EDM is often better for small batches with tight tolerances, fine features, or delicate profiles. Choose laser cutting for speed. Choose wire EDM for detail control.

Can laser-cut laminations be used for motor testing?

Yes, but the test type matters. Laser-cut laminations are useful for fit, winding, thermal, spin, and early functional tests. For final magnetic validation, edge effects, burrs, stress, and heat treatment decisions need closer control.

What files are needed for a custom lamination stack quote?

Send a DXF or DWG file, a PDF drawing, material details, target stack height, lamination count if fixed, quantity, stacking method, burr requirements, and inspection needs. A STEP file is helpful for assembly context.

What is the fastest stacking method for prototype laminations?

A loose or clamped stack is usually fastest. A welded stack is often the fastest rigid assembly. Bonding can produce a cleaner stack but may add cure time and height-control steps.

Do prototype motor laminations need stress relief?

Not always. Stress relief is useful when magnetic performance, core loss, or simulation correlation matters. For fit checks and winding trials, it may not be necessary.

Should I choose exact stack height or exact lamination count?

Choose exact stack height when the prototype must fit a housing or meet an active length target. Choose exact lamination count when the magnetic design or test comparison depends on the number of sheets. If both matter, define the priority.

How can I reduce lamination stack lead time immediately?

Send clean cutting files, allow available material substitutes for early builds, mark only true critical dimensions, choose a simple stacking method, define burr direction, and include the prototype’s test purpose in the RFQ.

Final Rule

Build the first prototype lamination stack to answer the nearest expensive question.

If the expensive question is fit, build for fit. If it is winding, build for winding. If it is magnetic loss, slow down and control the process.

Fast does not mean careless. It means removing the decisions that do not matter yet, so the few that do matter get handled correctly.

Share your love
Charlie
Charlie

Cheney is a dedicated Senior Application Engineer at Sino, with a strong passion for precision manufacturing. He holds a background in Mechanical Engineering and possesses extensive hands-on manufacturing experience. At Sino, Cheney focuses on optimizing lamination stack manufacturing processes and applying innovative techniques to achieve high-quality lamination stack products.

New Product Brochure

Please enter your email address below and we will send you the latest brochure!

en_USEnglish

Let Sino's Lamination Stacks Empower Your Project!

To speed up your project, you can label Lamination Stacks with details such as tolerance, material, surface finish, whether or not oxidized insulation is required, quantity, and more.
